Environmental approvals in WA

Clearing permit, EPA referral, works approval or EPBC referral? Which environmental approvals a WA project needs, who decides each and what triggers it.

Environmental Approvals WA Trace Enterprises

In Western Australia, a project that clears native vegetation, affects threatened species or produces emissions can need one or more environmental approvals, from the State, the Commonwealth or both. Which ones apply depends on what the project will do and what is on the land.

This guide sets out the main approval pathways as at October 2026, who decides each one and what usually triggers it. For help with a specific project, see our clearing permit, EPBC Act referral and environmental impact assessment services.

Environmental approvals in Western Australia come from two levels of government. The State regulates under the Environmental Protection Act 1986 (WA) (the EP Act) and the Biodiversity Conservation Act 2016 (WA) (the BC Act). The Commonwealth regulates matters of national environmental significance under the Environment Protection and Biodiversity Conservation Act 1999 (Cth) (the EPBC Act). Each pathway has its own trigger and decision-maker, and an approval or exemption under one law does not by itself satisfy another.

In the Northern Territory, environmental impact assessment sits with the Northern Territory Environment Protection Authority under the Environment Protection Act 2019 (NT), which this guide does not cover.

The main approvals at a glance

The table sets out the five approvals covered in this guide, the law behind each, who decides and what usually brings it into play.

Main environmental approvals in WA (October 2026)
ApprovalLawDecision-makerTypical trigger
Environmental impact assessmentPart IV, EP ActEnvironmental Protection Authority (EPA) assesses; Minister for Environment decidesA proposal likely to have a significant effect on the environment
Native vegetation clearing permitPart V Division 2, EP ActDWER; DMPE for mineral and petroleum activitiesClearing native vegetation that is not exempt
Works approval and licencePart V, EP Act, and Schedule 1 of the EP RegulationsDWERBuilding or operating a prescribed premises
EPBC Act approvalEPBC ActCommonwealth Environment Minister or delegateA possible impact on a matter of national environmental significance
Threatened species authorisationBC Act, section 40State Minister, with applications administered by DBCATaking or disturbing threatened flora or fauna

In short, each approval has a different trigger, and one project can need several of them at once.

How to work out which approvals apply

The answer depends on what the project will do and what is on the land. These checks are a sensible order to run them in:

  1. Define the proposal. Map the full footprint, including clearing, construction, access and any ongoing operations or emissions.
  2. Screen for national matters. The Commonwealth's Protected Matters Search Tool shows matters of national environmental significance that may be in or near a project area.
  3. Check clearing. Work out whether any clearing is exempt or needs a permit, and whether the land is in an environmentally sensitive area.
  4. Check for prescribed premises. Compare the activity against Schedule 1 of the Environmental Protection Regulations 1987 (WA).
  5. Check for threatened species. Threatened flora, fauna or ecological communities on the site can trigger a BC Act authorisation.
  6. Test significance. If the proposal could have a significant effect on the environment, request a pre-referral meeting with EPA Services.

Several of these checks need field data, so flora and fauna surveys often start early.

Part IV: environmental impact assessment by the EPA

Part IV of the EP Act deals with significant proposals. Section 37B defines a significant proposal as one likely, if implemented, to have a significant effect on the environment. The Environmental Protection Authority (EPA) assesses it and reports to the Minister for Environment, who decides whether it may be implemented.

Under section 38, the proponent or any other person may refer a significant proposal to the EPA. A decision-making authority must refer a proposal as soon as it has notice of it, if the proposal appears to be significant or of a prescribed class. The EPA can also require a proposal to be referred (section 38A).

Deciding whether to assess

Referred proposals are published for seven days of public comment on whether the EPA should assess them. Section 38G gives the EPA 28 days after the referral to decide, not counting time spent on a request for further information under section 38F. If the EPA decides not to assess, it publishes a summary of its reasons.

How the assessment runs

Since 1 January 2026, the EPA's Environmental Impact Assessment Practice Guide has replaced its earlier Administrative Procedures and Procedures Manual. Prescribed levels of assessment have given way to three questions: is more information needed, how should it be sought, and is public review needed and for how long. A simple proposal with well-understood impacts can be assessed on the referral information alone. Public review of the environmental review document typically runs for four to 12 weeks.

While a proposal is being assessed, section 41 stops decision-making authorities from making restricted decisions that could allow it to be implemented. Restricted decisions are set by regulation and currently cover decisions under planning legislation and certain decisions on petroleum activities involving hydraulic fracturing, so other State approvals can generally be progressed in parallel, although none of them can authorise the proposal to be implemented.

The EPA report and the Ministerial Statement

The EPA's assessment report is open to appeal for 21 days after it is published. The Minister then consults key decision-making authorities and decides whether the proposal may be implemented. A Ministerial Statement records the limits of the proposal and its implementation conditions. The proponent can appeal the conditions within 14 days of the Statement being issued.

Part IV assessment: key periods
StageProvisionPeriodBasis
Public comment on a referralEIA Practice GuideSeven daysEPA practice
EPA decides whether to assessSection 38GWithin 28 days of referral, not counting section 38F information requestsStatutory
Public review of the environmental review documentSection 40Typically four to 12 weeksEPA practice
Appeal on the EPA reportSection 100(1)21 days from publicationStatutory
Proponent appeal on Ministerial Statement conditionsSection 100(3)14 days from issueStatutory

The 28-day decision and the appeal periods are set by the Act; the comment and review periods are EPA practice. None of them is a guide to total assessment time.

Native vegetation clearing permits

Part V Division 2 of the EP Act regulates clearing of native vegetation. You generally need a clearing permit unless an exemption applies or the clearing referral process has found that a permit is not needed. Some exemptions do not apply in environmentally sensitive areas, which are shown on the Clearing Permit System map.

The Department of Water and Environmental Regulation (DWER) assesses most applications. The Department of Mines, Petroleum and Exploration (DMPE) has delegated authority for clearing for mineral and petroleum activities, and clearing on land not covered by mining tenure or petroleum titles goes to DWER. Other State or Commonwealth requirements can still apply to exempt clearing. Our guide to clearing permit exemptions in WA covers exemptions, referrals and permit types.

Works approvals and licences for prescribed premises

Prescribed premises are premises that could cause pollution or environmental harm to the environment, water resources, public health or amenity. Their categories are listed in Schedule 1 of the Environmental Protection Regulations. A works approval is needed before a prescribed premises is built, and causing an emission or discharge is an offence unless the premises holds a licence or registration. DWER administers these approvals under Part V of the EP Act.

At the pre-application stage, the applicant confirms whether an approval is needed and whether the proposal should also be referred to the EPA. Applications are then validated, advertised for public submissions and assessed, and the applicant can comment on the draft decision before DWER finalises it. Appeals go to the Office of the Appeals Convenor and are decided by the Minister for Environment.

Commonwealth approval under the EPBC Act

The EPBC Act protects nine matters of national environmental significance, grouped here into six headings:

  • declared World Heritage properties and National Heritage places;
  • wetlands of international importance listed under the Ramsar Convention;
  • listed threatened species and ecological communities, and listed migratory species;
  • Commonwealth marine areas and the Great Barrier Reef Marine Park;
  • nuclear actions, including uranium mines;
  • water resources, in relation to coal seam gas and large coal mining development.

It also covers actions on or affecting Commonwealth land and actions by Australian Government agencies. Commonwealth guidance says you need to refer a project if it could affect a protected matter, and that referral gives legal certainty. You can refer even if you are unsure whether the impact will be significant.

Once a referral is validated and published, a decision period of 20 business days begins, with public comment open for the opening 10 business days. The Minister or a delegate then decides whether the project is a controlled action needing assessment and approval, not a controlled action, not a controlled action if done in a particular manner, or clearly unacceptable.

Reforms due by 1 December 2026

The EPBC Act is being amended in stages. The National Environmental Protection Agency says the new approval tests start on or before 1 December 2026, and the four National Environmental Standards made on 19 August 2026 will apply to assessments and approval decisions once those tests commence. Our guide EPBC changes from 1 December explains what changes for current referrals.

Threatened species authorisations under the BC Act

A Ministerial authorisation is needed to take or disturb threatened fauna (section 40 of the BC Act) and to take threatened flora. The Department of Biodiversity, Conservation and Attractions (DBCA) administers applications, and there is no fee. Clearing for mining or development is one example of an activity that can need one.

An EP Act approval does not remove the need to authorise taking threatened fauna, although DBCA advises that an activity lawful under the EP Act, including under an exemption, does not need a section 40 authorisation just to disturb threatened fauna. DBCA advises that a project with EP Act approval that may still take threatened fauna requires a section 40 authorisation, and that approval to clear native vegetation does not replace a threatened flora authorisation. DBCA notes penalties of up to $500,000 for taking threatened flora without authorisation. Modifying a threatened ecological community needs a separate authorisation under section 45, and species listed under the EPBC Act may also need Commonwealth approval.

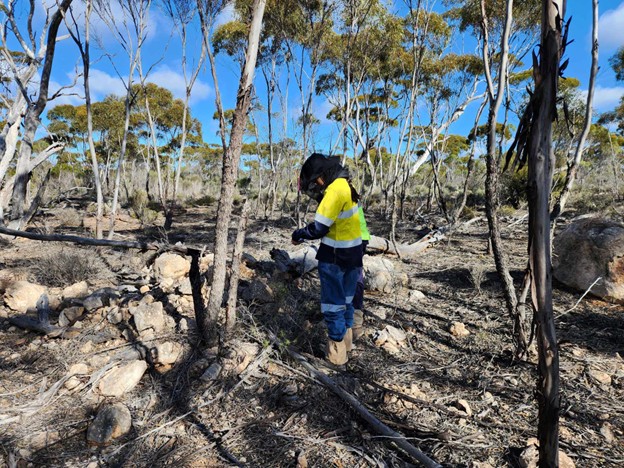

How surveys feed into approvals

Every pathway above depends on knowing what is on the land. The EPA's technical guidance sets the standards for flora and vegetation surveys and terrestrial vertebrate fauna surveys used in impact assessment, with separate guidance for subterranean fauna and short-range endemic invertebrates. Our guide to flora and fauna survey levels explains each survey type.

Land-based biodiversity survey reports submitted under the EP Act, including for impact assessment, clearing permits, works approvals and licences, need to be accompanied by a data package for DWER's Index of Surveys for Assessments. The requirement applies to field surveys that generate new data, not desktop studies.

How Trace Ecology helps

Trace Ecology is the environmental division of Trace Enterprises. We help proponents work out which approvals apply before a design is fixed, and we carry out the flora and vegetation surveys and fauna surveys those approvals rely on. We prepare referrals and supporting documents through our environmental impact assessment services, and exemption checks and applications through our clearing permit services. Where a project also raises heritage or planning questions, Trace Archaeology and Trace Planning can work alongside us. See our environmental consulting services in Perth, or talk to an environmental consultant about your project.

Frequently asked questions

Does my project need EPA approval?

Part IV applies to proposals likely to have a significant effect on the environment. If that is possible, a pre-referral meeting with EPA Services is the usual starting point. Once a proposal is referred, the EP Act gives the EPA 28 days to decide whether to assess it, not counting time spent on any request for further information.

Can one project need a clearing permit and EPBC approval?

Yes. A clearing permit is a State approval under the EP Act, and EPBC approval is a separate Commonwealth decision about matters of national environmental significance. Each is assessed under its own law.

How long does environmental approval take in WA?

It depends on the approval and the proposal. The EP Act sets a statutory period of 28 days for the EPA to decide whether to assess, and the EPBC Act referral decision period is 20 business days. Timing after that varies with the level of assessment, information requests and public review.

What is a Ministerial Statement?

It is the document issued when the Minister for Environment decides a Part IV proposal may be implemented. It sets the limits of the proposal and the conditions it must meet.

This article is general information as at October 2026, not legal advice.

References

All accessed 30 October 2026.

  1. Environmental Protection Act 1986 (WA), version 09-y0-00, current from 19 February 2026, sections 37B, 38, 38A, 38F, 38G, 40 and 41. legislation.wa.gov.au: Environmental Protection Act 1986
  2. Environmental Protection Authority, Environmental Impact Assessment Practice Guide: Assessment of Proposals in Western Australia under Part IV of the Environmental Protection Act 1986, Version 1.0, 6 November 2025 (sections 2.1, 3.1, 3.3, 3.4, 6 and 9). epa.wa.gov.au: EIA Practice Guide (PDF)
  3. Environmental Protection Authority, Environmental Impact Assessment Practice Guide web page (published 12 November 2025, revised 18 February 2026). epa.wa.gov.au: EIA Practice Guide page
  4. Department of Water and Environmental Regulation, Native vegetation clearing permits (last updated 1 July 2026). wa.gov.au: native vegetation clearing permits
  5. Department of Mines, Petroleum and Exploration, Native vegetation clearing permits and referrals (last updated 2 July 2025). wa.gov.au: DMPE clearing permits
  6. Department of Water and Environmental Regulation, Licences and works approvals for prescribed premises (last updated 6 October 2026). wa.gov.au: licences and works approvals
  7. Department of Water and Environmental Regulation, Stages of assessment for works approvals and licences (last updated 7 June 2023). wa.gov.au: stages of assessment
  8. National Environmental Protection Agency, EPBC Act protected matters and referral requirements (web page, undated). nationalepa.gov.au: protected matters and referral
  9. National Environmental Protection Agency, Referral applications and proposals (web page, undated). nationalepa.gov.au: referral applications
  10. National Environmental Protection Agency, Next tranche of environment protection reforms and National Environmental Standards (web page, undated; refers to Standards made 19 August 2026). nationalepa.gov.au: next tranche of reforms
  11. Department of Biodiversity, Conservation and Attractions, Authorisation to take and disturb threatened fauna (web page; application form dated 19 June 2026). dbca.wa.gov.au: threatened fauna authorisation
  12. Department of Biodiversity, Conservation and Attractions, Authorisation to take and disturb threatened flora (web page, undated). dbca.wa.gov.au: threatened flora authorisation
  13. Department of Water and Environmental Regulation, Program: Index of Surveys for Assessments (last updated 13 October 2025). wa.gov.au: Index of Surveys for Assessments
  14. Environmental Protection Authority, Technical guidance (list of current technical guidance, undated). epa.wa.gov.au: technical guidance
  15. Northern Territory Environment Protection Authority, Environmental assessments (web page, undated). ntepa.nt.gov.au: environmental assessments
  16. Environmental Protection Regulations 1987 (WA), Part 2B (restricted decisions), inserted by the Environmental Protection Amendment Regulations (No. 4) 2024. legislation.wa.gov.au: Environmental Protection Amendment Regulations (No. 4) 2024
  17. Government of Western Australia, Parallel decision-making policy. wa.gov.au: Parallel decision-making policy
